What Can Safely Be Compressed in a Rush Promo Order—and What Cannot

rush promotional products planning

In a rush order, compress waiting time, not verification time. Reversible accelerations, such as faster approvals, parallel proof review, courier samples, extra factory shifts, split shipments, and expedited freight, usually add cost or handling but can be undone or absorbed. High-risk shortcuts, such as skipping sample approval, required testing, or pre-shipment inspection, move a failure to a point where it cannot be fixed before the event. This guide is written for operations managers planning rush promotional product orders for US and UK events, who hold a standard schedule and a firm event date. Durations are illustrative and assumptions are dated October 20, 2026.

Time pressure makes this a current priority, because the instinct under a deadline is to remove the steps that look slowest, and those are often the steps that catch problems. The sections below provide a scorecard that separates reversible acceleration from high-risk shortcuts, a framework with a named decision owner, a worked schedule that compresses a standard plan to fit a shorter window, a stress test of the remaining buffer, and a set of triggers and fallbacks for delivery contingency.

Hands reviewing promotional product order paperwork beside canvas tote bags, insulated bottles, notebooks, and shipping boxes in a bright studio workspace.

Turnaround Planning: Where Rush Time Actually Hides

A promotional order spends its time in two kinds of steps. Some are waiting steps, such as internal approvals, queues for proofs, samples in transit, production slots, and freight transit. Others are verification steps, such as sample approval, product testing, and pre-shipment inspection, which exist to catch problems while they can still be fixed. Rush time is easiest to find in the first kind.

Compressing a waiting step usually costs money, such as a courier fee or an overtime charge, and leaves the check intact. Compressing a verification step costs nothing up front and moves the risk to a later point, often after the goods have shipped. Rush promotional products planning works best when it protects every verification step and buys time from the waiting steps instead.

Decision Table: Scoring Each Compression Lever

Score each lever from 1 (low) to 3 (high) on three questions. Reversibility asks whether it can be undone, with 1 meaning it can be undone for the cost alone. Detectability asks how late a failure would show, with 3 meaning only after delivery. Consequence asks how bad the worst case is, with 3 meaning a missed event, a compliance breach, or a safety exposure.

LeverReversibilityDetectabilityConsequenceRisk scoreClass
Same-day internal sign-off by a pre-agreed approver1113Reversible acceleration
Courier shipment of samples with same-day review1113Reversible acceleration
Air express instead of standard freight1113Reversible acceleration
Split shipment with a first lot sized for the event1124Reversible acceleration
Extra shift or overtime at the factory1225Conditional, needs mitigation
Skip pre-shipment inspection3227High-risk shortcut
Skip sample approval3238High-risk shortcut
Skip required product testing3339High-risk shortcut
Comparison of a properly stitched cream canvas tote and a defective tote with loose seams, illustrating promotional product sample approval and quality control.

Reversible Accelerations in Detail

The table below details the reversible levers from the scorecard: what each compresses, the illustrative time it saves, the cost direction, and the evidence to confirm before relying on it. Days are business days and illustrative.

LeverWhat it compressesIllustrative days savedCost directionEvidence to verify
Pre-agreed approver and same-day sign-offInternal approval2None or minorA named approver and an agreed response time
Parallel proof review and an approved artwork templateDesign and proof2Minor design timeTemplate approved by the brand team and a proof turnaround commitment
Courier shipment of samples with same-day reviewSample cycle4Courier feeA dated courier quote and the supplier’s sample dispatch time
Extra shift or overtime at the factoryProduction3Overtime or expedite chargeWritten capacity confirmation and an in-line quality plan for the shift
First lot sized for the eventProduction3Extra freight and handlingSupplier agreement to split, with per-lot MOQ and pricing
Air express instead of standard freightFreight and customs3Higher freight costA dated freight quote and customs documents ready before dispatch

Buyer Framework: How to Compress a Schedule Without Skipping Checks

The steps below turn the scorecard into a repeatable process. The decision owner is typically the operations manager, with procurement obtaining supplier quotes and a quality or compliance reviewer protecting the verification steps.

  1. Start from the event date and the supplier-quoted standard schedule, and calculate the gap in business days.
  2. List every compression lever and score each on reversibility, detectability, and consequence.
  3. Apply reversible accelerations first, and request dated quotes for every expedite fee before committing.
  4. Put a mitigation on each conditional lever, such as in-line quality checks for an extra shift, and record who owns it.
  5. Recalculate the schedule and the contingency left. If it is below your minimum, reduce scope, for example by prioritizing event-critical items, instead of cutting a verification step.
  6. Agree triggers and fallbacks with the supplier before ordering, so decisions are made at set points and not in a crisis.
  7. Record the assumptions with dates, and review the plan against what happened after the event.

Hands reviewing a cream canvas tote sample, product checklist, fabric swatches, and promotional merchandise artwork in a bright studio workspace.

Evidence From the Field: Illustrative Worked Schedule

An operations manager at a mid-market company plans conference giveaways. The standard schedule runs 51 business days, but only 35 business days remain before the event, a gap of 16. The plan applies the six reversible levers and leaves the testing, inspection, and delivery buffer steps as they are.

PhaseStandard (business days)Rush plan (business days)Lever applied
Internal approval and brief31Same-day sign-off by a pre-agreed approver
Design, artwork, and proof53Parallel review and an approved artwork template
Sample made, shipped, and reviewed106Courier shipment and same-day review
Product testing77Not compressed
Production159Extra shift, and a first lot sized for the event
Pre-shipment inspection22Not compressed
Freight and customs63Air express
Delivery buffer (receiving, kitting, staging)33Not compressed
Total513417 days saved

The six levers save 17 business days, taking the plan from 51 to 34 days against 35 available. That fits the window but leaves one business day of contingency, under 3% of the window. For comparison, skipping testing would save a further 7 days and show 8 days of apparent contingency. That buffer would be unusable if a product failed a required test after shipping, because a retest and replacement could not be completed before the event.

Hands packing promotional gift boxes with canvas tote bags, sage green bottles, burgundy notebooks, and plush fox toys in a clean fulfillment workspace.

Sourcing Risk: High-Risk Shortcuts and Why They Cannot Be Recovered

Rush orders also raise sourcing risk, because a supplier under pressure, or a new supplier brought in at the last minute, is less likely to have the checks in place. The table below lists shortcuts that turn a schedule problem into a failure that surfaces too late to correct.

ShortcutWhat it skipsWhat can go wrongRecoverable before the event?
Skip sample approvalA physical check of color, fit, and finishThe whole run is off specification and is found on deliveryNo, a full reproduction would exceed the time left
Skip required product testingEvidence the product can be placed on the marketA hold, a retest, or a withdrawn productOften no; requirements depend on product, use, and market
Skip pre-shipment inspectionAn independent check of the finished goodsDefects are found only on arrivalRarely; minor rework may be possible on site
Approve artwork without a proofA check of placement, scale, and colorA misprint across the runNo
Switch to an unvetted supplierAn audit and a track recordGaps in capacity, quality, or complianceNo, the order is already placed
Substitute material without approvalConformity to the specificationChanges in performance or complianceNo

Required testing and documentation depend on the product category, intended use, and destination market. The primary sources listed below explain what applies in the US and the UK, and a compliance reviewer should confirm the requirement before any step is shortened.

Gloved hands inspecting reinforced stitching on a cream canvas tote against a quality checklist, with product samples and a plush fox in the background.

Delivery Contingency: Stress-Testing the Remaining Buffer

A schedule that fits is not the same as a schedule that is resilient. The table tests the one-day buffer in the worked example against delays that commonly occur, each treated on its own.

ScenarioAdded daysDays over the bufferResponse
Freight delayed by a day10Absorbed with no buffer left, so any second slip triggers a fallback
One extra proof round21Use the pre-approved fallback artwork, or accept a courier proof with same-day review
Production slips by two days21Move the first lot to the faster freight option, or reduce the lot size
Sample revision cycle43Switch to a fallback item, or cut scope to the event-critical items
Testing failure and retest76Replace the item, which is why the testing step is not compressed

Four of the five scenarios overrun a one-day buffer. The remedy is not to shave more from verification steps. It is to agree in advance what happens at each decision point, so the response is already chosen when a slip appears.

Decision pointTriggerFallback action
Artwork and proofArtwork is not approved at the end of the design windowUse the approved template version or a stock design
Sample reviewThe sample is not approved at the end of the sample windowSwitch to an in-stock alternative that meets the need
Production midpointThe first lot is behind its agreed milestoneReduce the lot size, or move the first lot to faster freight
InspectionInspection finds a defect rate above the agreed limitRework or release only the passing units, and prioritize event-critical items
Freight handoverCustoms documents or the booking are not readyRebook the next available service, or switch carrier

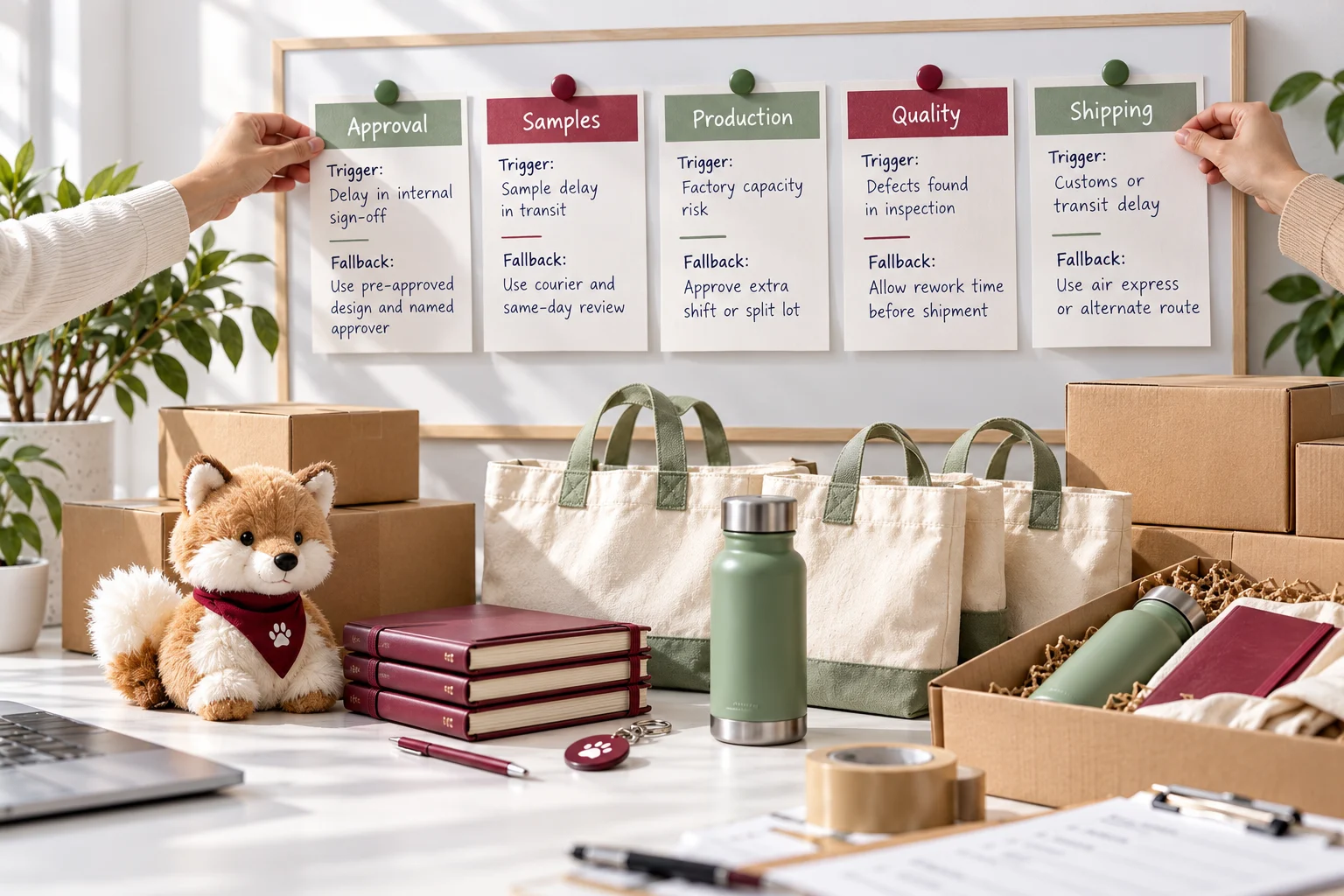

Promotional order contingency board showing approval, sample, production, quality, and shipping triggers with fallback actions in a bright studio workspace.

Risks and Limitations of This Approach

  • Durations are illustrative, and any reversible lever depends on real supplier capacity, so confirm each one in writing before relying on it.
  • Expedited freight and courier services reduce transit time but do not remove customs, documentation, or capacity constraints, which can still cause delay.
  • Scores are judgments; two reviewers may rate the same lever differently, so agree the scale in advance.
  • Requirements for testing and documentation vary by product category, intended use, and market, and a compliance reviewer should confirm them for your order.
  • This model does not include public holidays or factory closures, which can add days and should be built into your own calendar.
  • It is scoped to general promotional merchandise for US and UK events, and the worked example is illustrative.

Request a Scoped Quote

If you are planning a rush order, share your event date, quantity, product, and destination. Our team can help you request dated lead times and expedite options from suppliers in our network, so the schedule rests on written quotes.

Request a Scoped Quote →

Prefer a lighter first step? Send us your standard schedule and event date for a quick compression review before you commit.

Frequently Asked Questions

Can testing run in parallel with production?

Sometimes, but it is a conditional option in rush promotional products planning, not a risk-free shortcut. Starting production before test results arrive commits materials and capacity to a run that may need to be remade. This approach should only be considered when you can afford that outcome and a compliance reviewer agrees.

How much contingency should a rush plan keep?

Set your own minimum buffer based on your tolerance for a missed date. Effective turnaround planning accounts for the time needed at every stage, rather than relying on a single contingency day. When a plan falls below your minimum buffer, the better response is usually to reduce scope instead of removing an essential check.

What if the supplier offers to skip the sample?

Treat this as a prompt for questions, not a saving. Skipping the sample can increase sourcing risk by allowing design or production problems to go unnoticed until later. Ask for a courier sample or a pre-production proof instead; our sample approval process guide explains what each approval gate confirms.

When is a stock item a better answer than a rush custom order?

A stock item is often a better option when rush promotional products planning leaves almost no buffer or when a failure would be unrecoverable. A stock item with simple decoration can serve as a delivery contingency agreed in advance, potentially protecting the event better than a tightly scheduled custom order.

Is air freight always a reversible choice?

Air freight is reversible in the sense that it costs money without changing the product, but it depends on carrier capacity and ready customs documents. As part of turnaround planning, confirm both before counting on the time saved, and include the option in your delivery contingency plan only when the schedule and documentation support it.

Sources and Further Guidance

US Consumer Product Safety Commission — Children’s Product Certificate

UK Government — Placing Manufactured Products on the Market in Great Britain

International Chamber of Commerce — Incoterms® Rules

UK Government — Trade Tariff: look up commodity codes, duty and VAT rates

Author & Reviewer

Written by Claire Morgan, Senior Content Writer, with professional experience planning delivery schedules for promotional programs and events.

Freshness & Update Log

  • Published: October 20, 2026
  • Last Reviewed: October 20, 2026 (initial edition; assumptions dated this day)
  • Next scheduled review: within 6 months, or sooner if cited testing, documentation, or freight guidance changes materially.

Related Resources

Ready to Create Custom Promotional Gifts?

Share your product idea, quantity and branding requirements with our team.

Request a Quick Quote

Share your basic product requirements, and our team will review your enquiry and contact you to discuss the next steps.

Have more project details? Complete our full quotation form.
